Workstream 1: Design & Enablement Works
This workstream is the key to enabling the successful completion of all the delivery workstreams (W2-4) and is responsible for all client engagement, programme communications, document approvals and client coordination throughout Phase 5.
In addition, the following project activities are carried out under Workstream 1:
- planning
- surveys (incl. equipment nodes, infrastructure and fibre)
- design documents (incl. equipment nodes, infrastructure and fibre) through to sign off following the agreed processes developed during Phase 4

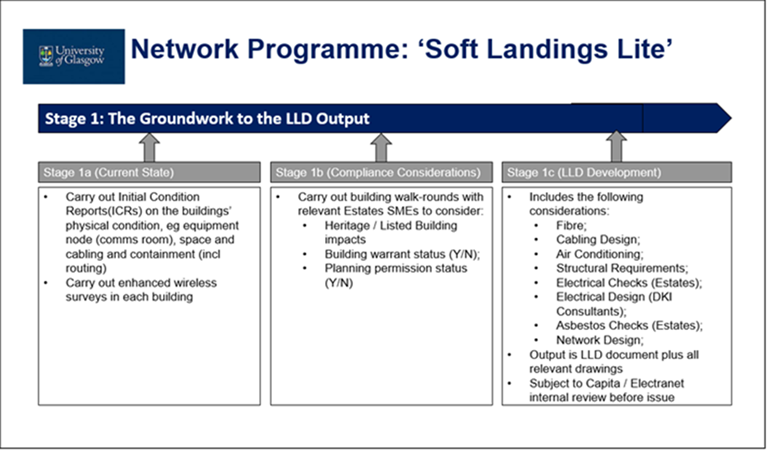

The approval process will follow the successful soft landings lite approach developed during Phase 4 with our colleagues in Estates for all the larger pieces of work.
It is currently envisaged that the design works will be completed 6 months prior to the end of Phase 5 (March 2028) with all surveys completed one month prior to that.
